wire harness

What Actually Drives the Price of a Custom Wire Harness

2026-10-21 15:48

What Actually Drives the Price of a Custom Wire Harness

A customer sent us two drawings in April. Same product family, same machine, same engineer. One was the 120 V North American variant, the other the 230 V European version. The harnesses were nearly identical — one different connector, a different wire colour scheme, and about 40 mm of extra length on two legs.

The quote came back at 4.10 USD for the first and 9.80 USD for the second.

The customer asked, reasonably, whether we had made a mistake. We had not. The 120 V version used a connector we buy 30,000 pcs of a year and keep in stock. The 230 V version used a sealed connector from a different series that we buy 400 pcs of a year, on a 14-week lead time, with a minimum buy of 1,000. Same copper. Same labour. Same test. More than double the price, because of one part number.

That is the whole subject of this article. Custom harness pricing is not mysterious and it is not arbitrary. It is a stack of about eight costs, and the cheapest quote you receive is almost never the one with the lowest costs — it is usually the one with the shortest stack, because some of it got left off.

What this article covers:

  • Why two quotes for the same drawing can differ by 40 percent, honestly

  • The eight cost blocks inside a harness price, and roughly how much each one weighs

  • Why connectors decide your price more often than anything else

  • What wire gauge and cable construction actually cost, and when they are being over-specified

  • How labour scales — and why a 30-wire harness is not three times a 10-wire harness

  • Testing: what each gate costs and what it buys you

  • Volume, setup, and why the price curve flattens when it does

  • The difference between unit price and landed cost, with the arithmetic

  • Ten places where a quote hides a cost you will pay later

  • Twelve legitimate ways to reduce the price without reducing the quality

  • The things you should not cut at any price

  • How to read a harness quote line by line

  • When the cheap quote is genuinely cheaper

  • Why work with us

Table of Contents

  1. Two quotes, same drawing, 40 percent apart

  2. The eight cost blocks in a harness price

  3. Connectors and terminals: usually the biggest line

  4. Wire, cable, and the cost of over-specifying

  5. Labour: how it actually scales

  6. Testing: what each gate costs

  7. Volume, setup, and the price curve

  8. Unit price vs landed cost

  9. Ten places where the quote hides a cost

  10. Twelve legitimate ways to reduce the price

  11. What you should never cut

  12. How to read a harness quote line by line

  13. When the cheap quote is genuinely cheaper

  14. Why work with us

  15. FAQ

Two quotes, same drawing, 40 percent apart

Buyers are told that competition keeps suppliers honest. In harness work, competition mostly produces spread, and the spread is not a measure of anyone's honesty. Two factories can quote the same drawing at 6 USD and 9 USD and both be telling the truth about their own costs.

Here is where the spread comes from:

  • They are buying different components. One factory buys that connector 30,000 pcs a year and gets distributor pricing. Another buys it 300 pcs at a time and pays list plus freight. Same part number, twice the material cost, and nobody did anything wrong.

  • They are running different processes. One has an automated cut-and-crimp wire processor. Another cuts and strips by hand. The automated one has capital to recover; the manual one has labour. Which is cheaper depends entirely on your quantity.

  • They are pricing different scopes. One quote includes 100 % electrical test, the other includes a visual check. One includes test records, the other includes the harness. This is where the very large spreads come from, and a 40 percent gap usually means a scope gap rather than an efficiency gap.

  • They are at different points in their own cycle. A factory with a half-empty line in a slow month will quote aggressively to fill it. That is a real price and a real opportunity — and a real risk, because the same factory cannot hold that price when the line fills up.

  • They are amortizing differently. Setup, tooling, and engineering are fixed costs. Spread over 1,000 units they add 0.40 USD each. Spread over 100 they add 4.00 USD. Same factory, same process, different quantity, a price that looks like a different company.

  • They are carrying different overhead. Calibration programmes, an engineering department, an ERP that holds traceability — all real money, all landing in the unit price. A factory without those things can genuinely be cheaper. It is also genuinely offering less.

So when the quotes come in, the useful question is not "why is this one cheaper?" It is "what is different about what I am buying?" The answer is almost always in the BOM, the process, or the test scope. A supplier who cannot explain their own price structure does not understand it either.

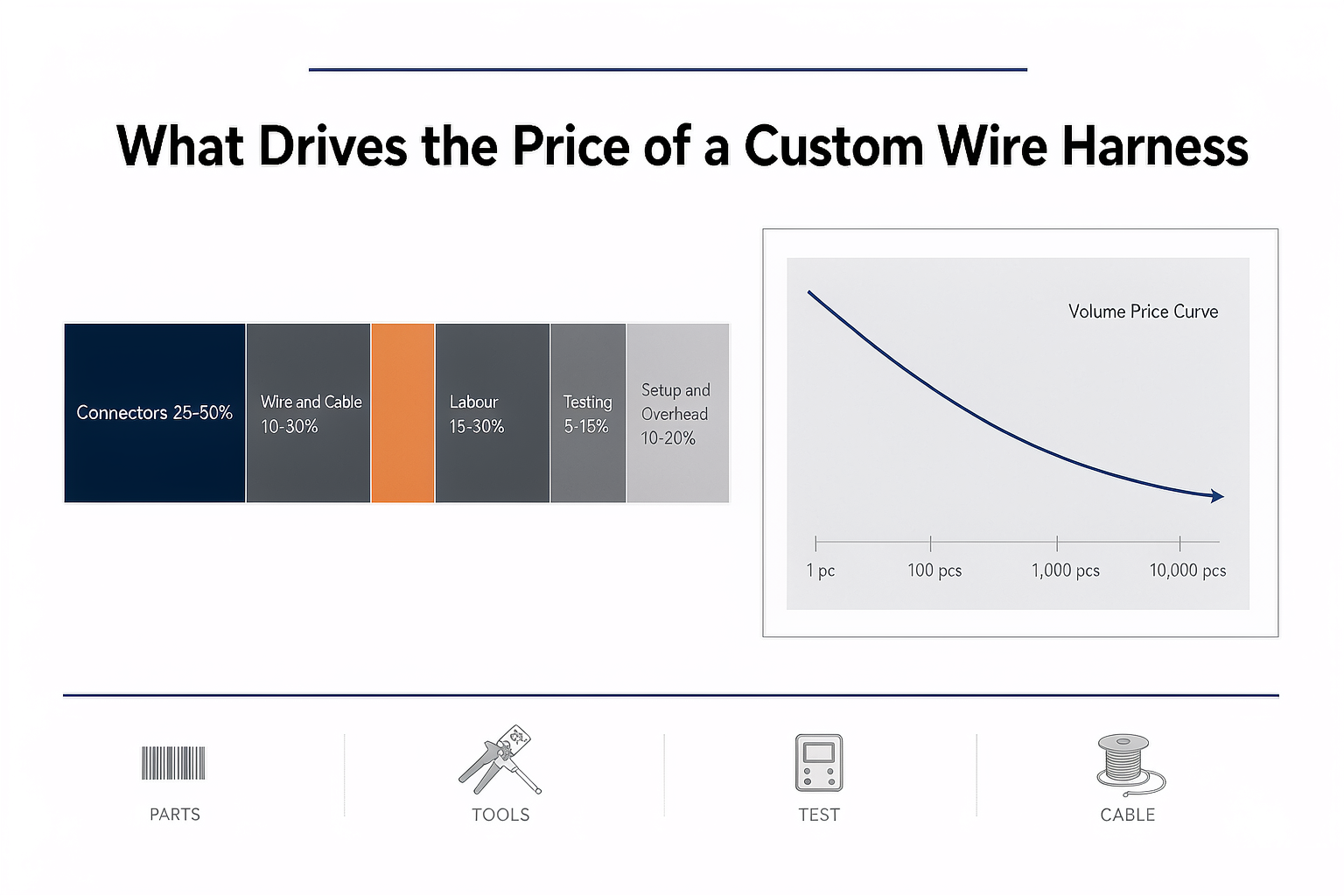

The eight cost blocks in a harness price

Every quote is a sum of the blocks below. The percentages shift with the product — a simple 4-wire jumper is mostly material and labour, a shielded high-speed assembly is mostly cable and testing — but the structure never changes.

Cost blockWhat is inside itTypical shareWhat moves it upWhat moves it down
1. Connectors and terminalsHousings, contacts, seals, CPA locks, boots, splices, ferrules25–50 %Sealed or automotive-grade series, brand-name parts, low purchase volume, long lead times, single-source partsStandard series instead of premium, consolidating part numbers, a qualified alternative, forecast visibility
2. Wire and cableConductor, insulation, shielding, jacket, fillers, drain wire10–30 %Large gauge, specialty insulation (silicone, FEP, XLPE), shielding, drag-chain or high-flex construction, multi-pair cableRight-sizing the gauge, dropping a shield you do not need, a standard jacket where the environment allows
3. LabourCutting, stripping, crimping, inserting, splicing, taping, tying, labelling, packing15–30 %High termination count, splices, tight tolerance, small wire, hand assembly, complex routingFewer terminations, welded splices instead of junction connectors, a design that suits automated processing
4. Overmolding, potting, encapsulationTooling amortization, molding cycle, material, yield loss0–20 %Custom tool, low volume, tight cosmetic requirements, multiple variants needing separate toolsHeat-shrink or booted construction where the environment permits, sharing tools across variants
5. Testing and inspectionContinuity, hipot, pull test, dimensional check, visual inspection, test records5–15 %100 % test on complex assemblies, high circuit count, hipot on every unit, TDR, functional test on a fixtureNothing — this is the block you should be protecting, not reducing
6. Setup and NREDrawing review, DFM, programming, applicator setup, first article, fixture build0–15 %, falls with volumeNew tooling, new test fixture, incomplete drawings, many variantsHigher quantity, reusing existing tooling, a complete drawing package on the first submission
7. Documentation and traceabilityTest records, material certificates, IMDS/PPAP if required, label data, batch traceability1–5 %Full PPAP, IMDS entries, per-unit test records, material declarationsAgreeing on the document pack you actually need instead of the maximum available
8. Overhead, margin, freight, riskFactory overhead, certification upkeep, scrap allowance, margin, packaging, freight10–20 %Export packaging, expedited freight, high-mix low-volume scheduling, tariff exposurePlanning freight with the production schedule instead of after it, consolidated shipments, realistic lead times

Two things worth noticing. The shares overlap because the categories do — a sealed connector costs more and takes longer to crimp. And the only block where the correct answer to "how do I reduce this" is "you don't" is testing. Everything else has legitimate room. Testing has legitimate room in scope, which is a different conversation from price.

Connectors and terminals: usually the biggest line

If you want to understand a harness price, start at the connector BOM. In most assemblies it is the single largest cost, and it is also the line item with the widest legitimate price range.

The same circuit function can be served by four different connectors spanning a 10× price range:

Connector classTypical applicationRelative costWhat you are paying forWhat you give up
Commodity wire-to-board (basic 2.54 mm pitch series)Internal signal wiring in a dry enclosure1×Nothing but functionNo sealing, limited mating cycles, no vibration retention
Industrial sealed circular (M8 / M12)Sensors and actuators in a machine, washdown or dust3–5×IP67–IP69K sealing, positive locking, 100+ mating cycles, field-installableMoney, and panel space
Automotive sealed (2.8 mm / 1.5 mm sealed series)Vibration, temperature cycling, underhood or chassis4–8×Vibration retention, wide temperature range, sealed cavities, high mating cycle lifeMoney, crimp tooling complexity, and often lead time
Heavy-duty industrial (rectangular multipole, high-current)Panel-to-panel, power distribution, quick connect for service6–12×High current, tool-free mating, robust mechanical protection, serviceabilityMoney, size, and the cost of a good crimp tool

Three things drive the connector line more than the connector class:

  • Purchase volume, which is not yours. A factory buying 30,000 pcs a year and one buying 400 are not in the same market, even for the same part number. When you ask for a quote, ask what volume the supplier buys that part at. If the answer is "we will buy what you need," you are paying list price plus a margin.

  • Lead time. A part on 14-week lead time is either bought against a forecast and carried as inventory — which is capital the supplier is financing for you — or bought per order, which means you wait. Either way, the price reflects it. A connector that is in stock somewhere is always cheaper than one that is not.

  • Minimum buy. A 1,000 pcs minimum on a part you need 80 of a month is 12 months of inventory sitting in a warehouse. Somebody pays for that inventory. The question is whether it is visible on your quote or buried in the unit price.

The practical takeaway: if you want to reduce harness cost and you have design freedom, look at the connector BOM before you look anywhere else. Consolidating four similar connector series into one, or accepting a qualified alternative from the same manufacturer's family, often moves the price more than every other optimisation combined. We do this review on every RFQ, and we tell customers when a part is expensive because of a volume problem rather than a technical one — the technical ones we cannot fix, but the volume ones are usually solvable.

Wire, cable, and the cost of over-specifying

Wire looks like a commodity and is not. A reel of 22 AWG PVC hook-up wire and a metre of shielded drag-chain-rated cable with a PUR jacket are different products in every dimension, including price.

What drives the wire line:

  • Gauge. Larger conductor means more copper. The cost is close to linear with cross-section once you get past small sizes, and the jump from 22 AWG to 18 AWG is roughly double the copper.

  • Insulation material. PVC is the cheapest. TPE costs more. PUR, silicone, FEP, and XLPE cost considerably more, and each one exists for a specific reason — chemical resistance, temperature, flexibility, or abrasion.

  • Stranding. Fine-strand conductor for flex applications costs more to make and more to crimp. Class 6 stranding can add 20–40 percent to the wire cost versus a standard stranding of the same gauge.

  • Shielding. Braid, foil, or combination. Braid costs more than foil, spiral-wrap more than braid, and any shield adds a drain wire and a termination step.

  • Specialty constructions. Drag-chain rated, torsion rated, high-temperature, low-outgassing, oil-resistant, halogen-free. Each of these is a real engineering answer to a real problem — and each one has a price.

Where over-specification bites is here: buyers often specify the harshest environment they can imagine instead of the one the product actually lives in. A shielded, silicone-jacketed, fine-strand cable on an internal harness that never moves, never sees more than 60 °C, and lives inside a sealed enclosure is money spent for nothing. It is not harmful. It is just 3× the cost of the correct part, and it makes every subsequent quote look expensive because the cable cost is locked in.

The reverse failure is more expensive. A general-purpose PVC harness in a machine that sees oil mist and continuous flex will fail, and it will fail inside the warranty period. There is no version of that arithmetic where saving 2 USD on cable is a good decision.

So the question to ask yourself on every wire line is not "what is the best cable for this" but "what is the cheapest cable that will still be working in year five?" Those are different questions, and the second one is the one that determines your total cost.

Labour: how it actually scales

Labour is where buyers most often misjudge a quote, because intuition says a harness with twice the wires should cost twice as much. It does not. Labour scales with terminations, not with wire count, and the relationship is not linear in either direction.

Assembly featureLabour impactWhy it matters more than wire count
Each terminal crimp and insertionHighest per-unit timeEvery circuit has two ends. A 30-wire harness has 60 terminations plus any splices — that is where the time goes, not in cutting the wire.
Sealed connector assembly2–3× an unsealed connector, per cavityWire seals, cavity plugs, CPA lock, and insertion force. A sealed 12-cavity connector takes longer than four unsealed 3-cavity connectors.
Splices and junctionsHigh, and a quality riskEach splice is a manual operation with a heat-shrink or boot step. A welded splice machine reduces it but requires tooling and volume.
Branching and breakout pointsModerateEvery branch needs a break-out, a tie, and often a label. Multi-branch harnesses are slower to assemble and much slower to inspect.
Looming, taping, and tie spacingLow per metre, but adds upA 2 m harness with 20 ties at a specified spacing is a different labour profile from a loose bundle.
Label placementLow individuallyFive labels per harness, heat-shrink printed and positioned — the time is real when the volume is high.
Process automation eligibilityCan cut labour 40–60 %Automated wire processing needs consistent wire types, lengths within a range, and quantities that justify setup. Hand assembly is not always the expensive option at low volume.

A worked comparison, using our own standard rates:

  • 10-wire harness, unsealed connectors, 0.6 m: 20 terminations, no splices. Roughly 6–8 minutes of direct labour.

  • 30-wire harness, sealed connectors, 1.8 m with three branches: 60 terminations, 4 splices, 3 break-outs, 8 labels. Roughly 35–45 minutes.

Three times the wire, five times the labour. That is the relationship you should expect, and any quote that scales linearly with wire count is a quote built on a spreadsheet instead of a process.

The other thing labour does is expose design decisions. Two designs that are electrically identical can differ by 40 percent in labour because one puts four circuits through a 12-cavity sealed connector and the other distributes them across three 4-cavity unsealed ones. Neither is wrong. One of them is cheaper, and it is worth knowing which before you freeze the design.

Testing: what each gate costs

Testing is usually 5 to 15 percent of the unit price, and it is the line where cheap quotes are made. Here is what each gate actually costs and what it prevents.

Test gateCost per unit (typical)Time per unitWhat it catchesCost of missing it
Automated continuity and short test0.10–0.50 USD20–60 sOpen circuit, short, wrong cavity, cross-wiringOne dead unit at the customer — a service call plus a return plus a reputation cost
Dielectric withstand (hipot)0.15–0.60 USD15–45 sInsulation breakdown, nicked conductor inside a bundleA safety failure, potentially a recall, potentially a liability claim
Pull force on crimps0.05–0.30 USD (destructive sample)Batch level, not per unitUnder-crimped or over-crimped jointsIntermittent faults that no continuity test will find, appearing at cycle 200
Dimensional check0.10–0.40 USD30–90 sLength error, connector position error, mounting hole mismatchA harness that will not fit, discovered at final assembly when the unit is otherwise complete
Visual inspection (trained operator)0.10–0.35 USD30–120 sCrimp condition, insulation damage, wrong keying, label errors, tie spacingCosmetic and latent defects that pass every electrical test
TDR / impedance verification1.00–5.00 USD1–3 minImpedance mismatch, return loss, connector termination quality on high-speed linesA cable that passes continuity and fails the signal — the classic USB/Ethernet failure
Functional test on a bench fixture2.00–15.00 USD2–10 minEverything that only appears when the harness meets the electronicsDiscovering an integration problem at your assembly station instead of at ours

Add the record-keeping. A test that runs but is not recorded is a test you cannot prove you did, which matters exactly once — when your customer audits you, or when a field failure forces you to identify which units to look at. The documentation block is 1–5 percent of the price and it is the cheapest insurance on the quote.

Our position is simple: 100 % electrical test and 100 % manual final inspection on every assembly, not sampled, and the records ship with the batch. On a 50-piece order that is maybe 15 USD of testing. On the same order, one escaped harness costs more than that in the phone call alone.

custom wire harness price

Volume, setup, and the price curve

Harness pricing is not linear in volume, and the shape of the curve surprises people. Fixed costs dominate at low volume, material discounts and automation take over at high volume, and the curve flattens somewhere in between.

QuantityWhat dominates the priceProcess usedRelative unit priceWhat to expect
1–10 (prototype)Setup, engineering, hand assemblyBench assembly, engineering attention on every unit4–8×You are buying learning, not parts. The price is high and it should be — you are paying for the design conversation.
10–100 (pilot)Setup amortization, still largely hand assemblyProduction tooling, small batch2–4×The first point where the price tells you something about the production price. Ask for a curve at the same time.
100–1,000 (low volume production)Material and labourProduction tooling, semi-automated wire processing1.0× (reference)This is where most of our customers live, and where the design decisions are still cheap to change.
1,000–10,000 (volume production)Material volume discounts, automationAutomated cut-and-crimp, dedicated setup0.70–0.90×Material discounts become real. Component minimum buys stop being a constraint.
10,000+ (high volume)Material only, and process efficiencyDedicated line, possible in-house tooling0.55–0.80×The curve flattens. Further reductions come from design changes, not from squeezing the process.

The practical move, and the one almost nobody does: ask for the price curve when you place the first order. Ask for a quote at your current quantity and at three future quantities. Two things happen. You find out whether the supplier's pricing is structurally sound — a proper factory can produce that curve without effort. And you find out where the big steps are, so you can plan a quantity that lands on the right side of one.

One warning about volume. There is a step change at the point where a part crosses a minimum buy, where automation becomes worthwhile, or where a tool gets amortized. If your annual volume is 900 pcs and the step is at 1,000, the honest answer may be that you should consolidate two orders into one. A supplier who tells you that is worth keeping, because they just cost themselves a purchase order.

Unit price vs landed cost

The number on the quote is not the number you pay. For an imported harness, the gap between unit price and landed cost is routinely 10 to 25 percent, and it is not evenly distributed across suppliers.

Line itemTypical magnitudeWho usually forgets itHow to get it right
Unit price (EXW or FOB)Reference—Ask which incoterm the quote uses. An EXW quote and a DDP quote are different products.
Export packaging0.5–3 %EveryoneHarnesses need structure, not bags. Ask for a photo of a packed carton before you approve the first order.
Inland freight to port and origin charges1–3 %First-time importersAsk for the FOB price, then ask what the origin charges are on top.
Ocean or air freight2–12 %Everyone, until the first invoiceAir freight on a 200 kg shipment can double the landed cost. Plan the schedule so you can use sea freight.
Duty and tariff0–15 %Everyone underestimating origin rulesDuty depends on component origin, not assembly location. Get the HS code and the origin declaration from your supplier.
Brokerage, handling, port fees0.5–2 %EveryoneAsk your freight forwarder for an all-in estimate before you approve the order, not after.
Incoming inspection and rework1–5 %, or much moreEveryone, and this is the expensive oneIf you inspect incoming shipments because you do not trust the supplier, cost that labour and add it to the landed cost. Then compare suppliers again.
Inventory carrying cost1–3 % per month of stock heldEveryoneA 1,000 pc minimum buy for 80 pcs a month means a year of stock. That is capital, storage, and obsolescence risk.
Field failure costWildly variableEveryone, until it happensThe only honest way to estimate this is to ask the supplier for their escape rate. A supplier who tracks it can answer. One who cannot is not measuring.
Your own management timeNever countedEveryoneChasing a supplier costs an hour a week and four years of it is a lot of hours. It belongs in the comparison.

Worked example, 500 pcs at a quoted 8.00 USD FOB:

  • Unit price: 4,000 USD

  • Packaging: 60 USD

  • Origin charges and inland: 90 USD

  • Sea freight: 180 USD

  • Duty at 5 %: 200 USD

  • Brokerage and port: 70 USD

  • Incoming inspection at 0.18 USD per unit: 90 USD

  • Landed: 4,690 USD, or 9.38 USD per unit

That is 17 percent above the quote, before anything goes wrong. A domestic supplier quoting 9.20 USD delivered is cheaper than the 8.00 USD quote, and the buyer who compared unit prices would have got that backwards.

Ten places where the quote hides a cost

A quote is not a lie when it omits these. It is a quote for a narrower scope than you assumed. These are the ten most common, in rough order of how much they cost when they surface.

#Hidden costHow it surfacesWhat to ask before you approve
1Testing scope"We need hipot records for the audit" — the price moves, and the timeline moves more"Which tests are included per unit, and is the data recorded and supplied?"
2Engineering change costsThree changes in year one, each billed as a setup, each adding a week"What does a post-production change cost, and what is the turnaround?"
3Component minimum buysA 1,000 pc reel for an 80 pc a month requirement, invoiced as inventory you did not plan"Which line items are constrained by a minimum buy?"
4Documentation packCertificates and declarations quoted as an option, then billed as NRE"What documents come with every shipment as standard, and what costs extra?"
5Freight and dutyThe landed cost is 17 % above the quote, and nobody warned you"Give me the incoterm and a landed-cost estimate for my country."
6Packaging adequate for the tripHarnesses arrive bent, connectors crushed, labels unreadable. You sort 500 units"How is this packed, and can I see a photo of a packed carton?"
7Sample cost recoveryThe sample was cheap because it was not built on the production process, so the real setup shows up on the first production order"Was this sample built on production tooling, and is the sample cost credited?"
8End-of-life and last-time buyA connector goes obsolete and the choice is 20,000 pcs or an emergency redesign"Do you flag component lifecycle risk at design stage, and do you hold buffer stock on long-lead parts?"
9Service parts after productionA customer needs one harness in year four, and the MOQ is 500"What is the MOQ on service parts after the program ends?"
10Yield and rework charged backA difficult assembly has a 12 % first-pass yield, and you are the one paying for the rework through a price increase at renewal"What is the first-pass yield on this assembly, and how is rework handled?"

None of these are tricks. They are the parts of a real production program that a supplier who is competing on the number alone has a structural incentive to leave out. The way to neutralise all ten is to ask for a quote with the scope spelled out — and to prefer the supplier who volunteers the awkward line items over the one who does not.

Twelve legitimate ways to reduce the price

There is a lot of room between "pay the first quote" and "buy the cheapest thing on the platform." These twelve moves are real, and none of them require you to accept a worse harness.

#MoveTypical savingRisk or trade-offWhere it applies
1Consolidate connector part numbers10–25 %May need a small design change and a re-validationAny harness with more than three connector series
2Right-size the wire gauge5–15 %Must be verified against current, drop, and temperature — never guessWhere a gauge was chosen "to be safe"
3Drop shielding you do not need5–20 % on that circuitOnly where EMC testing confirms it. Do not guess on this one either.Low-speed signals in a low-noise enclosure
4Replace junction connectors with welded splices5–15 %Not serviceable in the field, and requires toolingInternal branches that never get disconnected
5Standard jacket instead of specialty10–30 % on the cable lineOnly if the environment genuinely allows itDry, temperature-controlled enclosures
6Increase order quantity to the next price step10–30 %Working capital and storage; obsolescence if the design changesStable products with predictable demand
7Order in a schedule instead of ad hoc5–15 %Requires a forecast you can actually commit toAny repeat program. This is the easiest win and the least used.
8Reuse existing tooling or fixturesOne-time NRE reductionRequires the supplier to have a matching tool, or a modificationSecond-source or variant programs
9Accept a qualified alternative part5–20 %Needs a real equivalence review, not a datasheet comparisonLong-lead or premium-priced connectors
10Simplify the routing and branch count5–15 %Product redesign, so it is only cheap at the prototype stageAny new design, before freeze
11Ship by sea instead of air5–10 % of landed costLonger transit, more inventory in the pipelineRepeat orders with predictable demand
12Send a complete drawing package the first timeRemoves a whole round of cost and delayCosts you an afternoonEvery program. This one is free.

The two biggest savings on that list are not really about price at all. Consolidating connectors and sending a complete drawing both reduce the number of decisions the factory has to make on your behalf — and every decision a factory has to make for you is either a delay or a cost, usually both.

What you should never cut

There is a floor below which a cheaper harness stops being a harness and becomes a future problem. These are the things where the saving is small and the exposure is not.

  • 100 % electrical test. Saves cents per unit. Converts a controlled defect rate into an uncontrolled one, at your customer's site.

  • Proper crimp tooling and crimp height verification. Saves the cost of an applicator. Produces joints that pass a pull test by hand and fail after 200 mating cycles — the hardest failure to diagnose and the most expensive to explain.

  • Correct wire gauge for the current. Cheap right up until the harness runs warm, the insulation ages, and the failure happens at the worst possible ambient temperature.

  • Genuine, traceable components. Counterfeit connectors and terminals are a real market, and the price difference is exactly the size of the temptation. They look identical. They are not.

  • Sealing integrity on any outdoor or washdown assembly. A seal that fails at year two costs more than the sealed connector ever did.

  • Strain relief on any harness that gets handled. The number one mechanical failure in the field is not the wire — it is the transition where the wire meets the connector.

  • Documentation and traceability. Two percent of the unit price buys the answer to the question your customer will ask in an audit.

  • Change control. The cheapest possible process is the one that lets the workshop substitute a part to keep a schedule. That is not a process, it is a surprise with a delay on it.

Every item on this list is one or two percent of the unit price. Together they are maybe eight percent. There is no volume at which accepting the failure mode instead is the better trade — and we have watched customers try, more than once.

How to read a harness quote line by line

Most harness quotes are a number and a lead time. That is not enough information to make a decision, and you are entitled to ask for more. This is the structure we use, and what each line is for.

Quote lineWhat it should containWhat its absence tells you
Part number and revisionYour drawing number and revision, quoted back to youThe revision was not read. Ask which one they priced.
Component BOMPart numbers, manufacturer, quantity per unit, unit cost for eachThe price cannot be verified or compared, and substitutions become invisible
Wire scheduleGauge, insulation, colour, length, per circuitGauge substitution is the most common silent change in the industry
Labour and processA stated process (hand, semi-automatic, automatic) and the labour basisThe supplier does not know, or does not want you to know
Test scopeExactly which tests, on what percentage of units, with records or not"Inspection included" means nothing and is designed to mean nothing
PackagingInner and outer packaging, quantity per carton, protection methodBulk bags, and a sorting job on arrival
Tooling and NRESeparate line, with what it covers and whether it is one-timeHidden in the unit price, so you cannot compare at another quantity
Quantity breaksPrice at three quantitiesNo structural pricing — the supplier is quoting a number, not a cost model
Lead timeSample lead time and production lead time, stated separately, with the long-lead components namedA single optimistic number that will not survive contact with a component shortage
Incoterm and validityEXW/FOB/DDP stated, and how long the quote holdsYou will discover the freight later, and the price will "change" when you order
Payment termsDeposit and balance, or net termsUnclear cash flow on a first order is a bad sign on both sides
Change policyECO turnaround and cost, and what counts as a changeEvery small change will become a negotiation

You do not need all twelve lines on the first email. You need them before you place the order, and any factory that builds harnesses for a living can produce them without effort. The ones who cannot are telling you how the next four years will go.

When the cheap quote is genuinely cheaper

It would be convenient if the expensive quote were always the better one. It is not. Sometimes the cheaper supplier is simply better at the thing you are buying, and paying more is just paying more.

The cheap quote is genuinely cheaper when:

  • The supplier buys your components at real volume. A factory that already consumes 50,000 pcs a year of your connector has a structural advantage that no amount of negotiation will close. If they can show you the purchase volume, the price is real.

  • Your design fits their process. A factory that specialises in exactly your assembly type — say, sealed circular connectors on fine-strand cable — will beat a generalist on both price and quality, because their tooling and their habits are already pointed at your problem.

  • The scope is the same. Compare the two quotes line by line. If both include 100 % test, both include records, both include the same component BOM, and one is 20 percent cheaper, that is an efficiency difference and you should take it.

  • You have verified the factory. Not the website. A video call from the production floor, a test record from a previous shipment, and a first article you inspected yourself. Cheap and verified is the best outcome available.

  • You are buying a simple assembly. A short jumper with two crimped terminals and no sealing has a low technical ceiling. There is less for a bad supplier to get wrong, and the value of a quality system is proportionally smaller.

And the cheap quote is not cheaper when the difference is in a scope line you did not read, when the supplier cannot answer a technical question, when the components are a substitution you did not approve, or when the price has an expiry date that arrives before your production date.

The practical test: ask the cheaper supplier to explain why they are cheaper. A good one will tell you — volume, process, tooling, geography, their own idle capacity. A bad one will say "we are more efficient" and change the subject. The explanation is the product.

Why work with us

We are a custom wire harness and cable assembly factory in Xiamen. We quote with the structure shown above — component BOM, wire schedule, test scope, packaging, tooling as a separate line, and prices at three quantities — because a quote you cannot read is a quote you cannot compare.

What you get on a price conversation:

  • A DFM review before the price, free, in 48 hours. If we think a wire is oversized, a connector is unnecessary, or a shield is doing nothing, we will say so and show you the saving. That happens before you order, when you can still act on it.

  • Component BOM shown line by line. Part number, manufacturer, quantity, unit cost. You can check it against your own distributor pricing and see exactly where the money goes. If a component forces a minimum buy, we will name it.

  • Prices at three quantities plus the cost curve. So you can see where the steps are and plan around them instead of guessing.

  • 100 % electrical test and 100 % manual final inspection on every assembly, with records shipped with the batch. Not sampled, not optional, and not a line we will remove to win a price comparison. Our test equipment list includes an automated harness tester, hipot tester, terminal pull tester, crimp height gauges, optical measurement, and a microscope for cross-section work.

  • Build to print from whatever you have. Complete drawing, partial schematic, Excel BOM, photo of a competitor's assembly, or a sketch with dimensions. Reconstructing the document set with you is part of the job and we do it at no charge on a new program.

  • 5-day ECO turnaround. The changes that most affect your cost later are the ones you make in year one. We keep that cheap and fast on purpose.

  • Low-volume realistic. MOQ 100 pcs for a new program, pilots of 10–50 pcs priced honestly with the setup visible. We will not invent a minimum to avoid small orders, and we will not hide one in the unit price.

  • Multi-variant BOM management. If your product ships in voltage, regional, or trim variants, we hold the variant matrix and ship the right harness for the right build — which is also how you avoid paying for a universal harness nobody needs.

  • A supplier who will tell you to buy less. Twice this year we have told a customer their harness was over-specified and quoted them a cheaper one. It costs us a little on the order and it is the reason they are still customers.

We will not be the cheapest quote you receive. We will be the one you can read line by line, the one that still answers your email in year four, and the one whose test records are on file when your customer audits you.

Frequently Asked Questions

Q1: Why is my custom wire harness quote so much higher than a catalogue cable assembly?
Because it is a different product. A catalogue assembly is built in volume, on a fixed design, with a known BOM and no engineering. Your harness has a drawing review, component sourcing at your volume, a setup, a first article, a test programme, and documentation. On a 100 pc order, the setup and engineering are a large fraction of the price and they are all one-time. Ask for the same harness priced at 1,000 pcs — that number, not the first one, is what your product's cost structure will look like.

Q2: What is the single biggest lever on harness cost?
The connector BOM, in most assemblies. It is typically 25 to 50 percent of the unit price and it has the widest legitimate range — the same electrical function can be served by parts spanning a 10× price difference. If you have design freedom, look there first. Consolidating four similar connector series into one, or accepting a qualified alternative for a long-lead premium part, routinely moves the price more than every other optimisation combined. Wire gauge is second. Labour is third, and it scales with terminations rather than with wire count.

Q3: Can you give me a price before you review the drawing?
We can, but it will be a guess and it is not the number you should plan around. A price without a DFM review assumes the drawing is complete, correct, and buildable as drawn. In our experience about half of incoming drawings have at least one thing worth changing — a gauge that is marginal, a connector that carries 16 weeks of lead time, a bend radius the routing cannot provide. We would rather spend a day on the review and quote you once than quote you fast and re-quote after the sample.

Q4: How much does 100 % testing actually add to the price?
Typically 5 to 15 percent of the unit price, depending on circuit count and which gates apply. Automated continuity is cents per unit. Hipot is a little more. Pull force and dimensional checks are batch-level and cheap. On a 50-piece order the total is usually under 20 USD for the whole batch. For comparison, one escaped harness at your customer's site — a service visit, a replaced unit, and the email you have to write — costs more than the testing on that entire order. This is the one line we will not remove to match a competitor's price.

Q5: Do you offer volume discounts, and at what quantity do they start?
Yes, and they are structural rather than negotiated — they follow the fixed-cost and material-discount curve. Broadly, the reference price is at 100–1,000 pcs; 1,000–10,000 pcs is typically 10 to 30 percent lower; above 10,000 pcs it flattens out because there is nothing left to squeeze from the process and further reductions come from design. We quote three quantities as standard so you can see the actual steps. If your annual volume is just under a step, it is sometimes worth consolidating two orders into one, and we will tell you when that is the case.

Q6: What is the difference between your price and my landed cost?
For an imported harness, expect 10 to 25 percent on top of the FOB price, covering export packaging, origin charges, freight, duty, brokerage, and incoming inspection. Duty depends on component origin rather than assembly location, so the origin declaration matters as much as the HS code. Ask for an incoterm on every quote, and ask for a landed-cost estimate for your country — a domestic supplier quoting 15 percent more than an overseas FOB price is often the cheaper option once everything is counted.

Q7: Can you help me reduce the cost of a harness that is already in production?
Yes, and it is one of the more useful conversations we have. Send the current drawing, the current quote with its BOM, the annual volume, and any field failure history. We will look at the component BOM first, then gauge, then process, then volume structure, and come back with a list of options — what each one saves, what it costs in re-validation, and what risk it carries. Some of those options will be things we can do without any change to your drawing. Some will need a design change and we will tell you which ones are not worth it. Typical turnaround on that review is three to five working days.


Get a Quote You Can Actually Read

Send us the drawing — or the schematic, the BOM spreadsheet, the photo, or the sketch — and tell us the annual volume you expect and when you need the first units. You will get a DFM review, a component-level quote, prices at three quantities, and a landed-cost estimate if you tell us the destination country. Normally within 48 hours.

If you are currently paying a price you do not understand, send us the quote as well as the drawing. Comparing the two documents is usually where the savings are.

Email: [sales5@xmkehan.com]
Typical response time: 24 hours, Monday to Friday

SEO Keywords: custom wire harness price, wire harness cost, cable assembly cost, wire harness pricing, how much does a wire harness cost, wire harness price per unit, custom cable assembly quote, wire harness quotation, harness cost breakdown, connector cost wire harness, terminal cost cable assembly, wire gauge cost, AWG price difference, cable assembly labour cost, harness assembly time, crimp labour cost, wire harness testing cost, hipot test cost, 100% electrical test cost, harness NRE, harness tooling cost, overmolding tooling cost, wire harness MOQ, low volume wire harness price, wire harness volume discount, price curve cable assembly, landed cost wire harness, wire harness duty rate, HS code wire harness, wire harness FOB price, DDP wire harness, wire harness freight cost, harness packaging cost, cost reduction wire harness, design to cost harness, connector consolidation saving, over-specified cable harness, wire harness total cost of ownership, cheap wire harness supplier, wire harness price comparison, how to read a wire harness quote, wire harness quote template, wire harness supplier China price, Xiamen wire harness factory price.

Get the latest price? We'll respond as soon as possible(within 12 hours)
This field is required
This field is required
Required and valid email address
This field is required
This field is required
For a better browsing experience, we recommend that you use Chrome, Firefox, Safari and Edge browsers.
